Back to Lead Time Guide
Production Planning•14 min read
Why Your 6-Week Corporate Gift Box Quote Becomes a 13-Week Reality
Factory project managers explain the hidden gap between quoted production lead time and actual calendar time in custom corporate gift box manufacturing, and why buyer-side delays compound faster than most procurement teams anticipate.
When a procurement manager contacts us with an urgent corporate gift box requirement for their Q4 client appreciation program, the conversation typically follows a predictable pattern. They need 500 custom rigid boxes with foil-stamped logos, and they have eight weeks until their distribution date. We quote six weeks for production, they calculate two weeks for shipping, and everyone agrees the timeline works. Three weeks later, that same procurement manager is asking why we haven't started production yet—and expressing frustration that their "six-week timeline" is now in jeopardy.

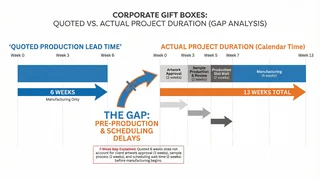

This scenario repeats itself with enough regularity that it reveals a fundamental misunderstanding about how production lead times actually function in custom manufacturing. The confusion centers on a critical distinction that most buyers overlook: the difference between production duration and project duration. When we quote "six weeks for production," we are specifying how long the manufacturing process takes once production-ready specifications are locked and a production slot is available. We are not promising that your order will arrive six weeks from the moment you send an initial inquiry email.
The gap between these two timelines—what suppliers mean when they quote lead time versus what buyers hear—creates the majority of delivery disappointments in corporate gift procurement. Understanding where this gap originates, and why it expands under certain conditions, changes how procurement teams should approach timeline planning for custom gift boxes.
Production lead time, in manufacturing terminology, refers specifically to the duration required to transform raw materials into finished goods once all specifications are finalized and production resources are allocated. For a custom corporate gift box with moderate complexity—let's say a two-piece rigid box with offset printing, spot UV finish, and magnetic closure—this manufacturing duration genuinely does fall within the six-week range we quote. Material procurement takes one week, printing and die-cutting require another week, box assembly and finishing consume two weeks, quality control and packaging add three days, and final preparation for shipment takes two days. That totals approximately 40 working days, or six calendar weeks, assuming no production interruptions.
But this six-week clock does not start ticking the moment a buyer sends a project brief. It starts when three preconditions are met: first, all artwork files are finalized in production-ready format with confirmed Pantone colors, dieline specifications, and material selections; second, physical samples have been produced, shipped to the client, reviewed, and formally approved without requested changes; and third, a production slot matching the required timeline is available and reserved with deposit commitment.
In practice, meeting these three preconditions consumes significantly more calendar time than most procurement teams anticipate. The first precondition—production-ready artwork—frequently requires two to three weeks of iteration, not because design work is complex, but because internal approval processes within the buying organization move slowly. Marketing needs to review brand compliance, legal must approve any text that could be construed as making product claims, finance wants to confirm the specifications align with approved budget levels, and the executive sponsor who ultimately signs off is traveling for two weeks. Each approval layer adds delays that the supplier cannot control or accelerate.
We have observed corporate clients take as long as four weeks to provide final artwork approval for what appeared to be a straightforward logo placement on a gift box. The design itself was simple—a single-color logo centered on the lid. But the logo file provided initially was RGB format pulled from their website, which would not reproduce accurately in CMYK offset printing. Converting to CMYK shifted the blue tone slightly cooler. Marketing requested a revision to match the original. This required a custom Pantone match, which added three days for color drawdown samples. Those samples needed to be photographed and circulated to stakeholders who were not available for in-person review. One stakeholder was on holiday. Another was managing a product launch and deprioritized the gift box approval. By the time we received formal sign-off, the project was already three weeks into what the buyer had calculated as an eight-week total timeline.
The second precondition—sample approval—introduces another timeline extension that buyers consistently underestimate. Producing a physical sample for a custom rigid box is not instantaneous. We must create the printing plates, run a short print batch, die-cut the components, hand-assemble the box structure, and apply any finishing treatments. This process takes five to seven working days. Shipping the sample to the UK adds another three to five days depending on customs clearance speed. The buyer then needs time to physically review the sample, circulate it internally for feedback, and communicate any requested changes. Even when clients respond quickly, this entire sample cycle consumes two weeks of calendar time. If the sample requires modifications—perhaps the magnetic closure feels too weak, or the interior foam insert does not securely hold the product—we must produce a revised sample and repeat the cycle, adding another two weeks.
We recently managed a project where the buyer approved the initial sample via email based on photographs, explicitly waiving physical sample review to "save time." Production proceeded, and 500 units were manufactured to the approved specifications. Upon delivery, the buyer's team discovered that the box interior color—which appeared neutral gray in photographs—read as slightly greenish under their office lighting. The entire batch required rework to replace the interior lining material. The rework consumed three additional weeks and exceeded the original production cost. Had the buyer invested two weeks upfront to review a physical sample under their actual lighting conditions, the project would have finished faster and cheaper.
The third precondition—production slot availability—represents the timeline factor that buyers most frequently fail to consider entirely. Manufacturing facilities do not maintain infinite unused capacity waiting for orders to arrive. Production schedules are planned in advance based on committed orders, and available slots are allocated according to deposit timing and order value. When a buyer contacts us in October requesting December delivery, we must evaluate whether our production schedule for November has available capacity. If our facility is already committed to other projects during the required production window, the buyer's project enters a queue and waits for the next available slot.
This queuing delay is not a supplier inefficiency or a negotiable inconvenience. It is a structural reality of manufacturing economics. Operating a production facility with significant unused capacity is financially unsustainable. Factories optimize for high utilization rates, which means production schedules are typically booked 80-90% full at any given time. The remaining 10-20% of capacity accommodates rush orders, rework requirements, and production overruns from complex jobs. When buyers delay their artwork approvals or sample reviews, they are not pausing a clock that can be restarted at will. They are losing their position in the production queue. By the time they provide final approval, the slot we had tentatively reserved may have been allocated to another client who was ready to proceed.
We encountered a particularly instructive example of this dynamic last year. A procurement team contacted us in early September for a corporate gift box order needed by mid-November. We quoted six weeks for production, and the buyer calculated that starting production by late September would meet their deadline. They requested samples, which we produced and shipped within the quoted timeframe. The samples arrived at their office in mid-September. We followed up weekly for approval but received no response. In early October—three weeks after samples were delivered—the buyer finally confirmed approval and requested immediate production start. By that point, our October production schedule was fully committed to other clients. The earliest available slot was mid-October, which pushed their delivery into late November, missing their distribution deadline. The buyer expressed frustration that we "couldn't accommodate their timeline," but from our perspective, we had held a production slot open for reasonable sample review duration. When that review extended beyond normal parameters without communication, we had no choice but to allocate the capacity to clients who were ready to proceed.

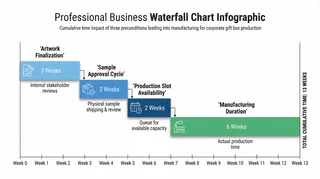

The compounding effect of these three preconditions explains why quoted production lead times and actual project timelines diverge so dramatically. A six-week production duration becomes an eight-week timeline when you add one week for artwork finalization and one week for sample approval. It becomes a ten-week timeline if sample revisions are required. It extends to twelve weeks if the buyer's internal approval processes are slow or if key decision-makers are unavailable. And it can stretch to fourteen weeks or longer if production slot availability is constrained during peak seasons.
Procurement teams who understand this distinction approach timeline planning differently. Rather than calculating backwards from their required delivery date using only the quoted production duration, they build comprehensive project timelines that account for all precondition phases. They establish internal deadlines for artwork finalization that precede the supplier's production start date by three weeks. They allocate two weeks for sample review and build in contingency time for potential revisions. Most importantly, they communicate with suppliers early about required delivery dates and ask explicitly about production slot availability, rather than assuming capacity will be available whenever they are ready to proceed.
The lead time challenge in custom corporate gift box procurement is not primarily a supplier capacity problem or a manufacturing efficiency issue. It is a coordination and expectation-setting problem. Suppliers can reliably deliver within quoted production timeframes when preconditions are met. But those preconditions require buyer actions and decisions that consume calendar time outside the supplier's control. Recognizing that production timelines depend on both manufacturing duration and client-side preparation phases allows procurement teams to plan more accurately and avoid the frustration of missed deadlines that could have been prevented with better timeline understanding.
But this six-week clock does not start ticking the moment a buyer sends a project brief. It starts when three preconditions are met: first, all artwork files are finalized in production-ready format with confirmed Pantone colors, dieline specifications, and material selections; second, physical samples have been produced, shipped to the client, reviewed, and formally approved without requested changes; and third, a production slot matching the required timeline is available and reserved with deposit commitment.
In practice, meeting these three preconditions consumes significantly more calendar time than most procurement teams anticipate. The first precondition—production-ready artwork—frequently requires two to three weeks of iteration, not because design work is complex, but because internal approval processes within the buying organization move slowly. Marketing needs to review brand compliance, legal must approve any text that could be construed as making product claims, finance wants to confirm the specifications align with approved budget levels, and the executive sponsor who ultimately signs off is traveling for two weeks. Each approval layer adds delays that the supplier cannot control or accelerate.
We have observed corporate clients take as long as four weeks to provide final artwork approval for what appeared to be a straightforward logo placement on a gift box. The design itself was simple—a single-color logo centered on the lid. But the logo file provided initially was RGB format pulled from their website, which would not reproduce accurately in CMYK offset printing. Converting to CMYK shifted the blue tone slightly cooler. Marketing requested a revision to match the original. This required a custom Pantone match, which added three days for color drawdown samples. Those samples needed to be photographed and circulated to stakeholders who were not available for in-person review. One stakeholder was on holiday. Another was managing a product launch and deprioritized the gift box approval. By the time we received formal sign-off, the project was already three weeks into what the buyer had calculated as an eight-week total timeline.
The second precondition—sample approval—introduces another timeline extension that buyers consistently underestimate. Producing a physical sample for a custom rigid box is not instantaneous. We must create the printing plates, run a short print batch, die-cut the components, hand-assemble the box structure, and apply any finishing treatments. This process takes five to seven working days. Shipping the sample to the UK adds another three to five days depending on customs clearance speed. The buyer then needs time to physically review the sample, circulate it internally for feedback, and communicate any requested changes. Even when clients respond quickly, this entire sample cycle consumes two weeks of calendar time. If the sample requires modifications—perhaps the magnetic closure feels too weak, or the interior foam insert does not securely hold the product—we must produce a revised sample and repeat the cycle, adding another two weeks.
We recently managed a project where the buyer approved the initial sample via email based on photographs, explicitly waiving physical sample review to "save time." Production proceeded, and 500 units were manufactured to the approved specifications. Upon delivery, the buyer's team discovered that the box interior color—which appeared neutral gray in photographs—read as slightly greenish under their office lighting. The entire batch required rework to replace the interior lining material. The rework consumed three additional weeks and exceeded the original production cost. Had the buyer invested two weeks upfront to review a physical sample under their actual lighting conditions, the project would have finished faster and cheaper.
The third precondition—production slot availability—represents the timeline factor that buyers most frequently fail to consider entirely. Manufacturing facilities do not maintain infinite unused capacity waiting for orders to arrive. Production schedules are planned in advance based on committed orders, and available slots are allocated according to deposit timing and order value. When a buyer contacts us in October requesting December delivery, we must evaluate whether our production schedule for November has available capacity. If our facility is already committed to other projects during the required production window, the buyer's project enters a queue and waits for the next available slot.
This queuing delay is not a supplier inefficiency or a negotiable inconvenience. It is a structural reality of manufacturing economics. Operating a production facility with significant unused capacity is financially unsustainable. Factories optimize for high utilization rates, which means production schedules are typically booked 80-90% full at any given time. The remaining 10-20% of capacity accommodates rush orders, rework requirements, and production overruns from complex jobs. When buyers delay their artwork approvals or sample reviews, they are not pausing a clock that can be restarted at will. They are losing their position in the production queue. By the time they provide final approval, the slot we had tentatively reserved may have been allocated to another client who was ready to proceed.
We encountered a particularly instructive example of this dynamic last year. A procurement team contacted us in early September for a corporate gift box order needed by mid-November. We quoted six weeks for production, and the buyer calculated that starting production by late September would meet their deadline. They requested samples, which we produced and shipped within the quoted timeframe. The samples arrived at their office in mid-September. We followed up weekly for approval but received no response. In early October—three weeks after samples were delivered—the buyer finally confirmed approval and requested immediate production start. By that point, our October production schedule was fully committed to other clients. The earliest available slot was mid-October, which pushed their delivery into late November, missing their distribution deadline. The buyer expressed frustration that we "couldn't accommodate their timeline," but from our perspective, we had held a production slot open for reasonable sample review duration. When that review extended beyond normal parameters without communication, we had no choice but to allocate the capacity to clients who were ready to proceed.
The compounding effect of these three preconditions explains why quoted production lead times and actual project timelines diverge so dramatically. A six-week production duration becomes an eight-week timeline when you add one week for artwork finalization and one week for sample approval. It becomes a ten-week timeline if sample revisions are required. It extends to twelve weeks if the buyer's internal approval processes are slow or if key decision-makers are unavailable. And it can stretch to fourteen weeks or longer if production slot availability is constrained during peak seasons.
Procurement teams who understand this distinction approach timeline planning differently. Rather than calculating backwards from their required delivery date using only the quoted production duration, they build comprehensive project timelines that account for all precondition phases. They establish internal deadlines for artwork finalization that precede the supplier's production start date by three weeks. They allocate two weeks for sample review and build in contingency time for potential revisions. Most importantly, they communicate with suppliers early about required delivery dates and ask explicitly about production slot availability, rather than assuming capacity will be available whenever they are ready to proceed.
The lead time challenge in custom corporate gift box procurement is not primarily a supplier capacity problem or a manufacturing efficiency issue. It is a coordination and expectation-setting problem. Suppliers can reliably deliver within quoted production timeframes when preconditions are met. But those preconditions require buyer actions and decisions that consume calendar time outside the supplier's control. Recognizing that production timelines depend on both manufacturing duration and client-side preparation phases allows procurement teams to plan more accurately and avoid the frustration of missed deadlines that could have been prevented with better timeline understanding.
