Lead Time

Why Your 'Approved' Design Doesn't Start Production Immediately

2026-01-078 min readQuality & Compliance Consultant

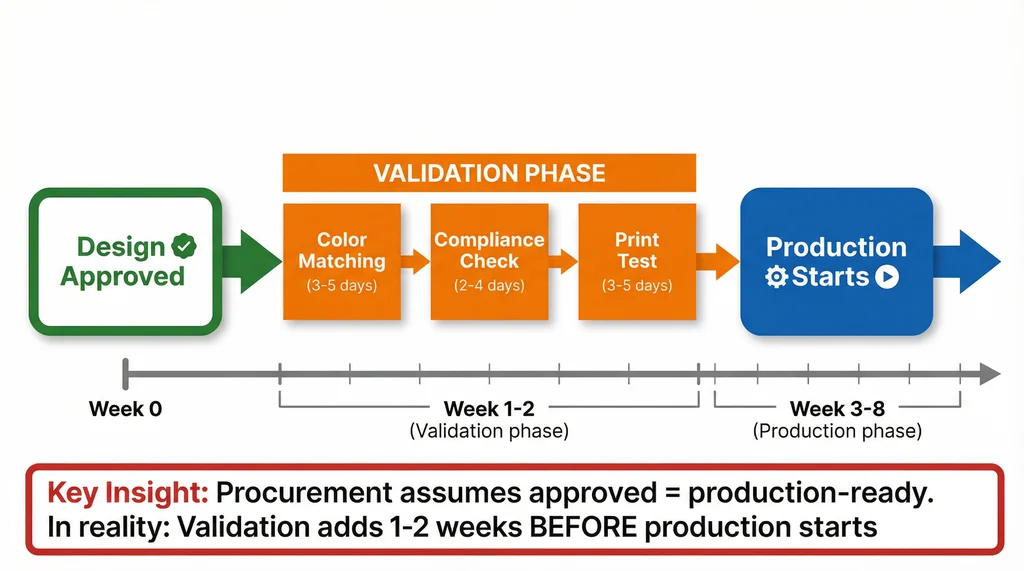

Timeline diagram showing design approval, validation phases (color matching, compliance check, print test), and production start. Validation phase spans 1-2 weeks before production begins.
The hidden validation phase adds 1-2 weeks between design approval and production start

When a procurement team receives a quote for a corporate gift box project—typically stating "6-week production lead time"—they often interpret this as the period between design approval and delivery. In practice, this assumption creates a systematic blind spot that surfaces only when the order enters the validation phase.

The confusion stems from a fundamental misalignment in terminology. When a factory quotes "6-week production lead time," they are referring specifically to the time required to physically manufacture the boxes after all pre-production validation has been completed and approved. What procurement teams frequently overlook is that design approval and production-ready status are not the same milestone. Between these two points lies a critical validation phase that, while invisible to the buyer, directly impacts whether the order can actually enter the production queue.

Consider a typical scenario. A procurement manager approves artwork for a rigid gift box with hot foil stamping. The design has been reviewed internally, the logo placement looks correct, and the color specifications have been confirmed. The factory receives this approval and places the order into what appears to be the production queue. However, what actually happens next is a series of internal quality and compliance checks that must be completed before production can begin.

First, the approved artwork moves into the pre-production validation workflow. This includes color matching against the physical substrate—the actual paper or cardboard that will be used. Digital color approval does not guarantee that the specified color will render correctly on the chosen material. A deep forest green that appears correct on screen may require ink formulation adjustments when applied to uncoated kraft paper. This validation step typically requires 3-5 business days, during which the order is in a holding state, not in active production.

Simultaneously, the factory's quality team runs compliance checks specific to the materials and finishes specified. For corporate gifts destined for certain markets, regulatory requirements around ink composition, material sourcing, or labeling standards must be verified. If the artwork includes any text or claims, these must be checked against local advertising standards or industry regulations. A gift box intended for distribution in multiple regions may require separate validation for each market's requirements. This compliance review can add another 2-4 business days to the pre-production phase.

The third validation step involves print test runs. For complex finishes like hot foil stamping, embossing, or multi-color printing, the factory produces a limited test batch to verify that the approved design can be executed at the specified quality level. This is not the sample that the buyer approved earlier—that sample was typically produced on a smaller scale or with manual finishing. The print test validates that the design can be replicated consistently across the full production run using automated equipment. If the test reveals issues—such as foil adhesion problems, embossing depth inconsistencies, or color registration errors—the artwork must be adjusted, and the validation cycle restarts.

This is where procurement's timeline assumptions begin to diverge from factory reality. When a print test fails, the factory does not simply resume production with the corrected artwork. Instead, the order re-enters the validation queue. If other orders have been approved during the validation period, those orders now have priority in the queue. The original order has not lost its production slot because it never actually entered production—it was still in validation. But from the factory's perspective, the validation failure means the order must be re-queued, and its position in the production schedule shifts backward.

Procurement teams often interpret this situation as a delay caused by the factory. In reality, the delay is a consequence of the validation requirements that exist to ensure the final product meets quality and compliance standards. The factory's quoted lead time of 6 weeks assumes that all validation will be completed successfully on the first attempt. If validation fails, the clock does not simply pause and resume—the order enters a new validation cycle, and production start dates shift accordingly.

The hidden cost of this blind spot becomes apparent when procurement attempts to expedite orders or negotiate tighter lead times. Pushing a factory to skip validation steps or compress the validation timeline creates a different kind of risk. Validation exists because the consequences of shipping non-compliant or poor-quality corporate gifts are severe. A batch of gift boxes with color mismatches or embossing defects damages the buyer's brand reputation. Non-compliant packaging can trigger regulatory issues or customer complaints. The factory's validation process is not bureaucratic overhead—it is a risk mitigation mechanism that protects both the factory and the buyer.

From a compliance perspective, the validation phase is also where regulatory and market-specific requirements are verified. Corporate gifts distributed across multiple regions may need to comply with different packaging standards, material sourcing requirements, or labeling regulations. A gift box that meets UK standards may not meet EU requirements for certain materials or inks. The validation phase is where these regional differences are identified and addressed. Skipping or compressing this phase creates exposure to regulatory non-compliance, which can result in customs delays, customer rejections, or reputational damage.

The procurement decision blind spot, then, is the assumption that "approved design" equals "production-ready design." In reality, approval is the beginning of validation, not the beginning of production. Understanding this distinction changes how procurement teams should structure their timelines and manage supplier relationships. Rather than viewing validation delays as factory inefficiency, procurement should recognize validation as a necessary quality gate that protects the integrity of the final product.

When negotiating lead times with suppliers, procurement teams should explicitly ask about the validation timeline and what happens if validation fails. A supplier who quotes 6-week production lead time but does not clarify that this excludes validation is either being deliberately vague or has not clearly communicated their process. A transparent supplier will break down the total timeline as: design approval → validation (3-7 days) → production (6 weeks) → shipping. This breakdown allows procurement to set realistic expectations and plan accordingly.

The practical implication is that procurement should add 1-2 weeks to any quoted production lead time to account for validation, assuming the order passes validation on the first attempt. If the order requires compliance verification for multiple regions or involves complex finishes, the validation period may extend to 3-4 weeks. This is not padding or inefficiency—it is the actual time required to ensure the gift boxes meet quality and compliance standards before they enter production.

For corporate gift box projects, where brand reputation and regulatory compliance are both at stake, the validation phase is not a cost center to be minimized. It is a value center that ensures the final product reflects the buyer's brand standards and meets all applicable regulations. Procurement teams that understand and respect this distinction will have more realistic timelines, fewer surprises, and ultimately, better outcomes with their suppliers. The key is recognizing that when you approve a design, you are not approving production—you are approving the beginning of a validation process that determines whether production can proceed safely and successfully.

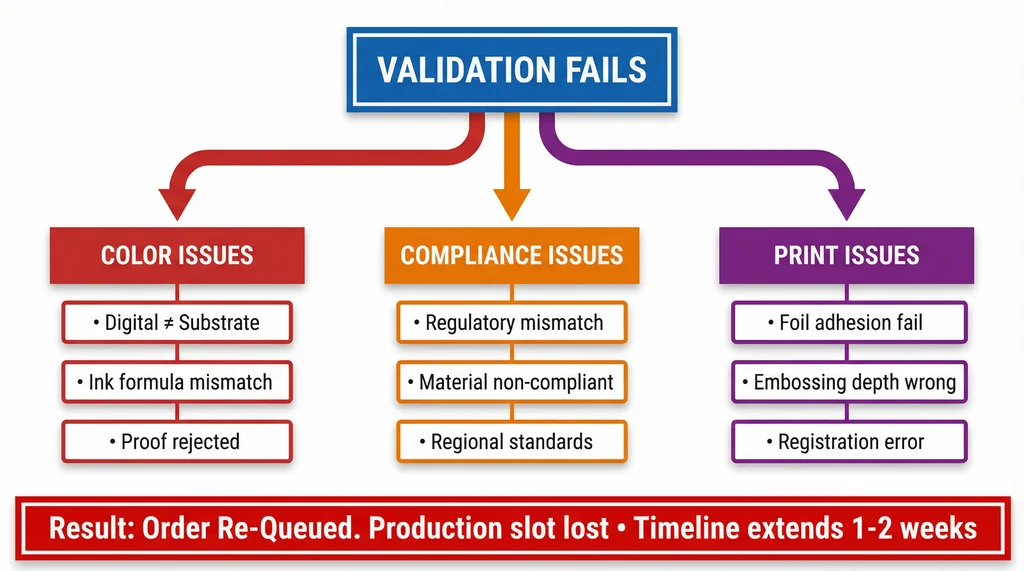

Decision tree showing three categories of validation failures: Color Issues (digital vs substrate, ink formula mismatch, proof rejected), Compliance Issues (regulatory mismatch, material non-compliant, regional standards), and Print Issues (foil adhesion fail, embossing depth wrong, registration error). Result: order re-queued, timeline extends 1-2 weeks.
Common validation failure points that cause orders to re-enter the queue

Understanding the validation phase is essential when reading our comprehensive lead time guide for corporate gift boxes, which covers all factors affecting total project duration. lead time guide for corporate gift boxes
