Why Your Packaging Material Choice Affects Lead Time More Than You Think
Customization Process••6 min read
Most procurement teams approach packaging material selection as if they were choosing between paint colours—assuming that once the aesthetic decision is made, everything else follows a predictable timeline. In practice, this is often where customization planning decisions start to be misjudged. The assumption that all packaging materials are equally available, with comparable lead times, reflects a fundamental misunderstanding of how different substrate categories flow through entirely separate supply chain structures.
When a corporate gift box specification calls for "textured linen paper with soft-touch lamination," the timeline impact isn't marginal—it's structural. The difference between commodity materials and specialty substrates isn't just a matter of a few extra days; it represents the gap between continuous stock availability and made-to-order production cycles that can extend timelines by 4–8 weeks before a single box is even printed.
The misjudgment typically occurs during the design approval phase. A client selects a material sample from a swatch book, and the procurement team records it as a specification detail, assuming the supplier will simply order the material and proceed. What isn't visible in that moment is that the chosen substrate—unlike standard white coated board—isn't sitting in a warehouse waiting to be cut. It's part of a production queue at a specialty mill that only runs that particular texture and weight combination when minimum order quantities justify a dedicated production run.

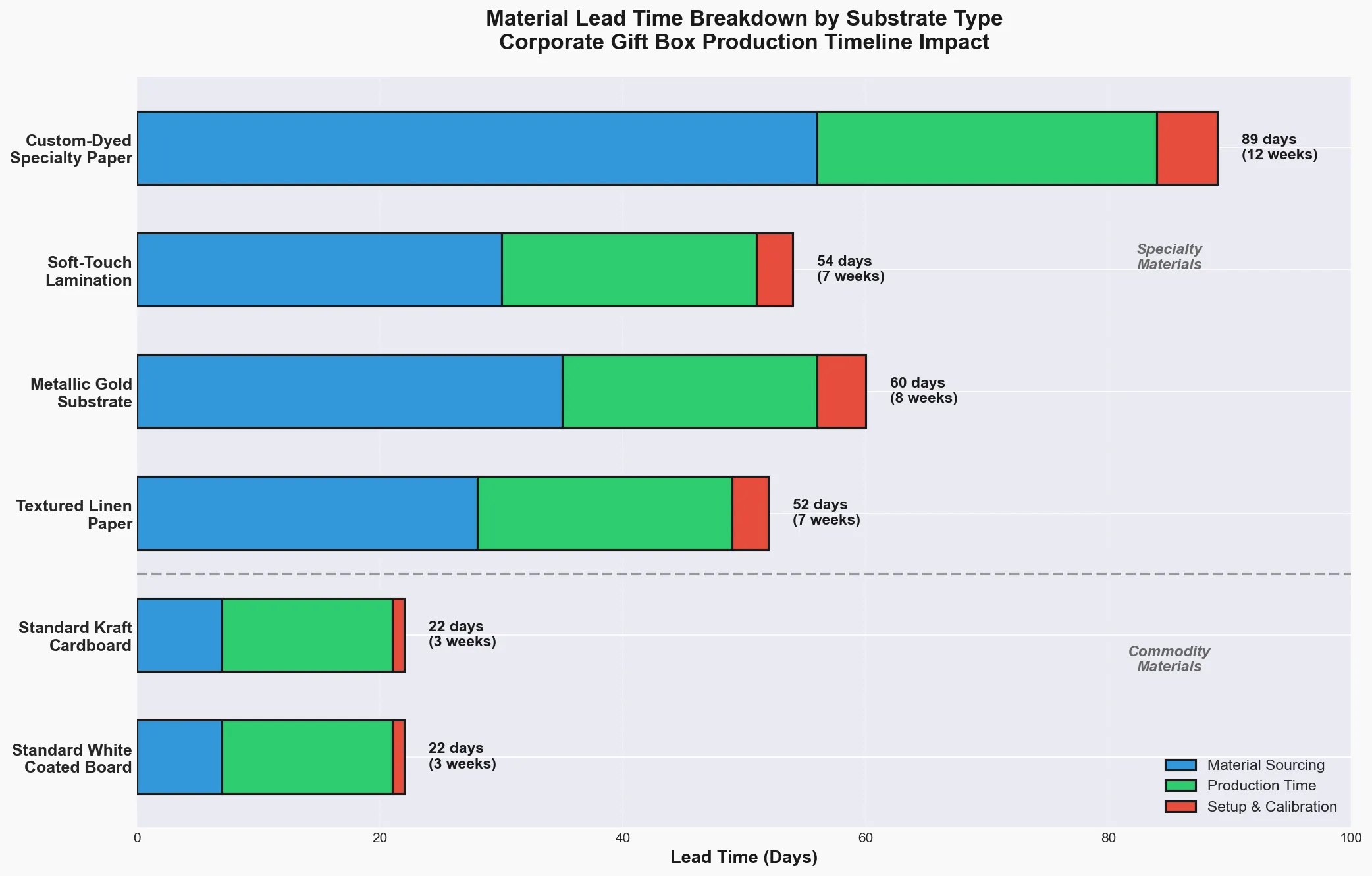

Commodity materials—standard kraft, white SBS (solid bleached sulfate), and uncoated chipboard—operate within a continuous supply model. These substrates are produced in massive volumes by large mills that maintain rolling inventory. A packaging supplier can typically source these materials within 5–10 business days because they're already manufactured, stored in distributor warehouses, and available in standard sheet sizes. The supply chain is optimised for volume and predictability, which is why most "standard" packaging projects can quote 3–4 week lead times with confidence.
Specialty materials function entirely differently. Textured papers (linen, canvas, leather-grain), metallic substrates (gold, silver, holographic finishes), and specialty coatings (soft-touch, velvet lamination, spot UV) are not continuously stocked. They're produced in batches by specialty mills that require minimum production runs—often 3–5 tonnes per texture and weight combination. If your corporate gift box order requires 500 units, and each box uses 0.8 square metres of material, you're requesting roughly 400 square metres of substrate. That's approximately 0.05 tonnes—far below the mill's minimum production threshold.
This creates a structural dependency: your order must wait until the mill accumulates enough demand from multiple clients to justify running that specific material. Depending on the popularity of the texture and the mill's production schedule, this can add 3–6 weeks before your supplier even receives the raw material. For less common specialty finishes—such as custom-dyed papers or proprietary textures—the wait can extend to 8–12 weeks, as the mill may need to schedule the run around other commitments and source specific pigments or additives.

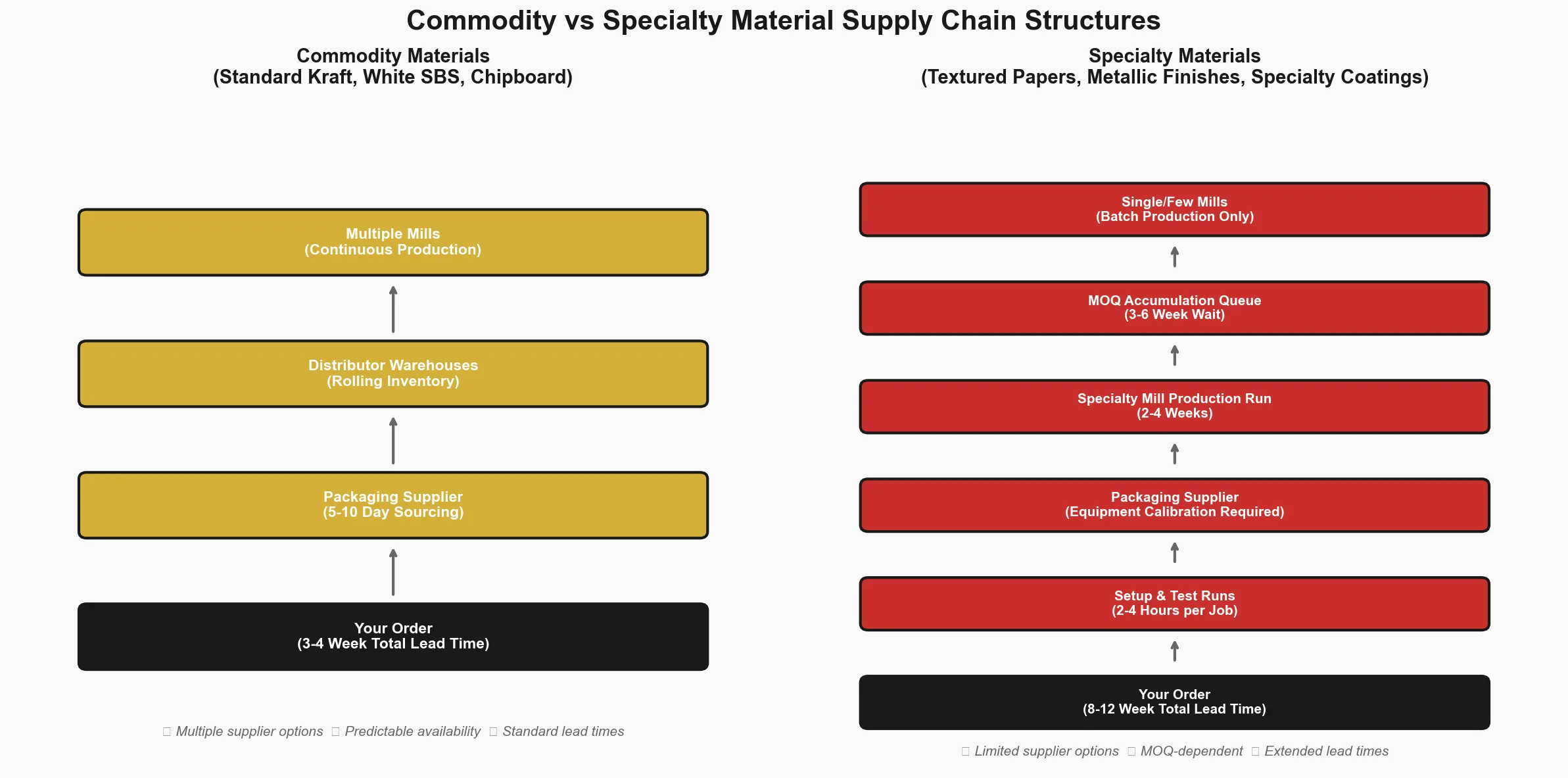

The second structural factor is supplier base concentration. Commodity materials are produced by dozens of mills across multiple regions, creating redundancy and competitive pricing. If one supplier faces a delay, alternatives exist. Specialty materials, by contrast, are often produced by a handful of mills—sometimes only one or two globally—that have invested in the specific equipment and expertise required to create those finishes. This concentration eliminates flexibility. If the specialty mill experiences a production delay, equipment malfunction, or raw material shortage, there's no alternative source. Your timeline is now tied to a single facility's operational status.
The third factor is material compatibility with existing production equipment. Commodity materials are engineered for broad compatibility—they run smoothly through standard die-cutting, printing, and finishing equipment without requiring calibration adjustments. Specialty materials, however, often demand equipment modifications. Textured papers may require adjusted die-cutting pressure to avoid crushing the texture. Metallic substrates can interfere with ink adhesion, necessitating specialised primers or UV-cured inks. Soft-touch lamination requires specific temperature and pressure settings that differ from standard film lamination.
Each of these adjustments introduces additional setup time and quality control checkpoints. A packaging supplier running a standard white coated board can switch between jobs in 30–45 minutes. Switching to a textured specialty substrate may require 2–4 hours of setup, test runs, and calibration. If your order is small—say, 500 units—the supplier must decide whether the setup time is economically justifiable, or whether to batch your job with other specialty material orders, further extending the timeline.
The compounding effect becomes visible when multiple specialty materials are specified. A corporate gift box design that calls for a textured outer shell, metallic inner liner, and soft-touch laminated lid isn't specifying three materials—it's specifying three separate supply chain dependencies, each with its own lead time, minimum order quantity, and production scheduling constraint. The cumulative delay isn't additive; it's multiplicative, because each material must arrive before the next production step can begin.
Procurement teams often discover this structural reality only after the order is placed, when the supplier provides an updated timeline that's 6–8 weeks longer than initially expected. The typical response is to question the supplier's efficiency or request expedited processing. But expediting doesn't resolve the underlying constraint: the specialty mill still requires its minimum production run, and the material still needs to be manufactured before it can be shipped. Paying for expedited freight might save 3–5 days on the back end, but it doesn't address the 4–6 week production queue at the front end.
The decision blind spot, then, isn't about failing to account for lead time—it's about assuming that material selection is primarily an aesthetic or cost decision, rather than a supply chain architecture decision. When a procurement team selects a specialty material, they're not just choosing a finish; they're opting into a fundamentally different production model that operates on longer cycles, higher minimums, and fewer supplier alternatives.
This is why experienced suppliers often recommend commodity materials for projects with tight timelines or lower order volumes. It's not about limiting design options—it's about aligning material selection with the realities of how different substrates are sourced and produced. A well-designed corporate gift box using standard white coated board with high-quality printing and finishing can achieve a premium appearance without introducing the structural delays inherent in specialty materials.
For projects where specialty materials are non-negotiable—because brand identity or product positioning demands a specific texture or finish—the solution isn't to compress the timeline. It's to extend the planning horizon. If a specialty material adds 4–6 weeks to the lead time, that constraint needs to be factored into the project schedule from the outset, not discovered midway through production. Early engagement with the supplier, combined with realistic timeline expectations, allows the specialty mill's production cycle to be incorporated into the overall project plan without creating last-minute delays.
The broader lesson is that packaging customization decisions—particularly material selection—are supply chain decisions. Every specification choice carries implicit dependencies on how materials are sourced, produced, and delivered. Procurement teams that treat material selection as a late-stage aesthetic detail, rather than an early-stage supply chain commitment, consistently encounter timeline surprises that could have been anticipated and managed with better upfront understanding of how different materials flow through fundamentally different production systems.
